KM3NeT - ARCA sea campaigns

Liveblogs during sea campaigns for ARCA

A very busy day, offshore and onshore

13 September 2021 – Still a day packed of activities today!

The status at the moment is that all interlink cables have been layed down on the sea floor and two detection units have been deployed and connected to the junction box. The detection units are still furled on their launcher vehicles; they will be allowed to unfurl tomorrow – since the launcher vehicle has to be recovered from the ship after it reaches the surface, it is better to perform this operation in the daylight.

Pre-unfurling functional tests performed from the onshore control station show that those first two detection units are in good order.

Deployments of the next detection units will continue during the night.

The onshore team in the control station at Portopalo di Capo Passero, Sicily, Italy.


















Good progress, despite adverse sea condition

12 September 2021 – there has been good progress in the operation so far!

The two cable reels are also deployed. The cables for connecting four detection units are already layed on the sea bottom and connected to the junction box. There is only one cable left to install.

While proceeding with these activities, however, the weather conditions worsened. The sky was still sunny, but waves mounted high: “We have a lot of sun here, but we are dancing a lot” commented Daniele Vivolo, who is among the KM3NeT team onboard the ship.

In such situation the risks when putting the equipment in water increase significantly. It was therefore decided to put the operation on hold, waiting for an improvement of the sea state.

In late afternoon, the sea had calmed down significantly, and the operations were resumed.

As we write this post, the first detection unit of the set of five included in this campaign is already in water, travelling into the deep, dark sea, down to 3,500 meters depth. There it will meet the ROV (the submarine vehicle operated from the ship), which will take care of the next steps: to assist in carefully positioning the detection unit on the sea bottom and to connect it to the cable already in place. Have a safe trip!

In the movie: the first detection unit is prepared for deployment.


First day of deployments at the ARCA site

11 September 2021 – operations are proceeding smoothly on Handin Tide.

The two new optical beacons of the positioning system are already placed on the sea bottom – these are autonomous devices not requiring a connection to the sea-floor network.

The deployment of the two reels carrying the long interlink cables for the detection units is proceeding. Installation of these cables requires time, because once a reel has reached the sea bottom, each cable has to be spooled off and layed down on the sea floor. These cables will be later used for connecting each detection unit to the submarine junction box which is already at the site (and connected to the 6 detection units already installed).

Once installation of the cables is completed, the deployment of the detection units can start – tomorrow!

The deck of the Handin Tide at the start of the operations (note that the yellow vehicle on the left is the Remotely Operated Vehicle – ROV – to be used for underwater operations).






















Liveblog about the ongoing sea operation for ARCA

10 September 2021 – In the evening of September 10, five new detection units of KM3NeT, onboard the Handin Tide, will sail from Malta headed to the KM3NeT/ARCA detection site. This site is located 80 km off the coast of Capo Passero, Sicily (Italy). During a 1-week operation, the detection units will be deployed and connected to the ARCA neutrino telescope at 3,500 m depth, adding up to the six already in operation.

The expectation is high for this new, important step in the construction of KM3NeT. Despite the pandemic, the Collaboration has worked hard to keep the high integration speed needed for such an ambitious project. The detection units include components prepared in various European laboratories, and also the integration, testing and installation of the units on their deployment vehicles was a joint effort of many different KM3NeT teams.

As we write this note, the detection units are safely restrained on the deck of Handin Tide, the ship crew and the KM3NeT offshore team are onboard and ready, and the ship is about to set sail. Onshore, everything is ready in the control station in Portopalo di Capo Passero. The motivation, everywhere, is very high.

We look forward to several days packed with hard work and documented with extraordinary images from the sea surface and the deep sea.

Follow the action while it takes place through our social media channels and our ARCA-blog!

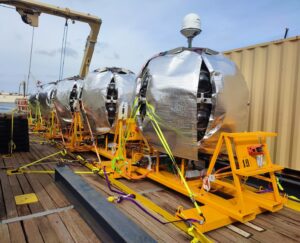

The detection units awaiting deployment on the deck of Handin Tide. Note that the equipment has been already prepared in the order in which it will be moved off the ship: first, two tripods carrying an acoustic beacon each (partially visible in the picture) for the acoustic positioning system, then the reels carrying long cables for connection to the existing submarine network on the sea floor, then the detection units.


Handin Tide left the harbour of Malta

10 September 2021 – the Handin Tide left the port of Malta around 5 p.m. CEST.

The navigation to the KM3NeT site is estimated to take about 10 hours.

The weather forecast is good. The activity on site will start early morning tomorrow.

Keep following the  ARCA-blog.
